The rule is simple: install cabinets before flooring if you’re using a floating floor (LVP, laminate, click-lock engineered wood). For tile, glue-down hardwood, and other fixed floors, install flooring first. That single distinction drives nearly every sequencing decision in a kitchen remodel.

Two immediate exceptions worth knowing:

Quick decision checklist before you schedule any trades:

  1. Confirm your floor material and whether it’s floating, glued, or nailed down
  2. Measure every appliance opening height and note your finished floor thickness
  3. Check the flooring manufacturer’s installation instructions for cabinet-placement language

Key Takeaways

For most kitchens, the flooring-or-cabinets decision comes down to one rule: floating floors require cabinets first, while tile and glue-down materials call for flooring first.

PointDetails
Floating floors: cabinets firstLVP, laminate, and click-lock engineered floors buckle and void warranties when pinned under cabinets.
Fixed floors: flooring firstTile and glue-down hardwood go in before cabinets for correct height references and moisture protection.
Appliance shimming is not optionalShim appliance bays to finished-floor height when cabinets go first; factory dishwasher preset is 34 1/2".
Floors-first adds $240–$600 in materialRunning flooring under cabinets in a mid-size kitchen costs more upfront but simplifies future cabinet swaps.
Trussell’s Transformations manages the sequenceThe team handles on-site measurements, manufacturer spec checks, and multi-trade coordination for Albuquerque kitchen remodels.

Table of Contents

Which flooring or cabinet sequence fits your material?

The table below maps the most common floor types to the correct install order. Use it as your starting reference before talking to a contractor.

Floor MaterialWhich Goes FirstKey Risk if Done Wrong
Tile (ceramic/porcelain)FlooringExposed subfloor seams under cabinets invite moisture damage
Solid hardwood (nail/glue-down)FlooringGaps appear when cabinets are removed later
Glued engineered hardwoodFlooringAdhesive bond disrupted by cabinet weight shifting
Floating engineered hardwoodCabinetsBuckling and voided warranty from restricted expansion
LVP / LVT (click-lock)CabinetsPinned planks cannot expand; buckling is common
Laminate (click-lock)CabinetsSame expansion restriction as LVP; warranty voided
Cork (floating)CabinetsCompression under cabinet base causes permanent indentation

Floating floors require expansion gaps of roughly 1/4"–1/2" around the perimeter and at any fixed obstruction. Cabinets sitting directly on a floating floor act as a fixed obstruction, which is exactly what manufacturers prohibit. For tile, the opposite logic applies: tile-first sets the correct countertop and appliance height relationships and protects the subfloor from future leaks under the cabinet base.

Cork deserves a specific note. Floating cork compresses under sustained point loads, so cabinet legs and base frames leave permanent impressions over time. Glued cork behaves more like a fixed floor and can tolerate flooring-first installation, but confirm with your product’s manufacturer spec sheet before deciding.

Pros and cons of installing cabinets first

Installing cabinets before flooring is the standard sequence on most remodels. Roughly 70% of contractors follow a cabinets-first approach because cabinets anchor countertop height, plumbing stub-outs, and appliance references from the start.

Pros:

  • You pay only for the flooring that’s actually visible, not the hidden area under cabinets
  • Cabinets anchor directly to the subfloor, giving a more stable base than a finished floor surface
  • Countertop height and plumbing rough-ins are set from a fixed reference point
  • Required for floating floors (LVP, laminate, click-lock engineered) to preserve expansion gaps

Cons:

  • If you ever replace cabinets, the floor underneath will be bare subfloor, creating a visible gap or requiring a patch
  • Appliance openings can end up at the wrong height if shimming is skipped (more on this below)
  • Toe-kick gaps may need filler strips to look finished against the flooring edge

Pro Tip: When installing cabinets first, use removable toe kicks rather than nailing them permanently. This lets you slide flooring under the toe-kick line later and gives you clean access for future appliance service without tearing out cabinetry. Custom and semi-custom cabinet options often include this feature as a standard detail.

Pros and cons of installing flooring first

Flooring-first gives you a continuous, uninterrupted floor surface that runs wall to wall, including under the cabinet footprint. For tile and glued hardwood, this is the professionally preferred sequence.

Pros:

  • Clean, seamless appearance with no visible floor gap if cabinets are ever replaced
  • Appliances can be removed and reinstalled without shimming the cavity
  • Tile under cabinets protects the subfloor from water intrusion at the cabinet base
  • Easier future cabinet swaps since the floor is already complete

Cons:

  • You pay for flooring material that’s permanently hidden under cabinets
  • Cabinet installation crews risk scratching, chipping, or cracking finished flooring during the install
  • Cutting flooring around existing cabinet bases takes more labor time than running it to an open subfloor

Running flooring under cabinets in a mid-size kitchen adds roughly $240–$600 in material cost depending on the material. For high-end hardwood, Angi cites professional installation costs of $13–$25 per square foot, so that hidden square footage adds up fast. Weigh that against the labor cost of cutting flooring around existing cabinet bases and the long-term benefit of a floor that doesn’t show a gap the day you update your cabinetry.

How do appliance openings and leveling affect your decision?

This is the most overlooked part of the flooring-or-cabinets decision, and it’s the one that generates the most expensive callbacks.

Dishwashers have a factory preset height of 34 1/2" (approximately 87.6 cm). When the finished floor doesn’t extend into the appliance bay, the dishwasher sits lower than the surrounding floor level. Sliding it out for service becomes difficult or impossible without damaging the floor edge. Some models allow wheel removal to fit a 33 1/2" opening, but that’s a workaround, not a plan.

Appliance installation guides specify a level, finished surface inside the opening, with shims, bracket attachment, and wheel-removal options to prevent binding. Skipping this step traps appliances in place.

Measurements to confirm before committing to a sequence:

  • Cabinet opening height (standard is 34 1/2" for dishwashers; confirm your model’s spec)
  • Finished floor thickness (tile with mortar bed runs 3/4"–1 1/4"; LVP typically 4–8 mm)
  • Whether your dishwasher wheels are removable and what the minimum opening height is
  • Range/oven slide-in clearance and whether the anti-tip bracket requires a finished floor surface

When cabinets go in first, use sleeper strips (plywood strips cut to finished-floor thickness) inside each appliance bay to raise the subfloor to the same height as the surrounding finished floor. This keeps every appliance at the correct service height.

Pro Tip: Secure sleeper strips to the subfloor with construction adhesive and screws before the appliance goes in. A loose shim shifts when the dishwasher is pulled out, which can crack tile edges or bind LVP planks at the opening.

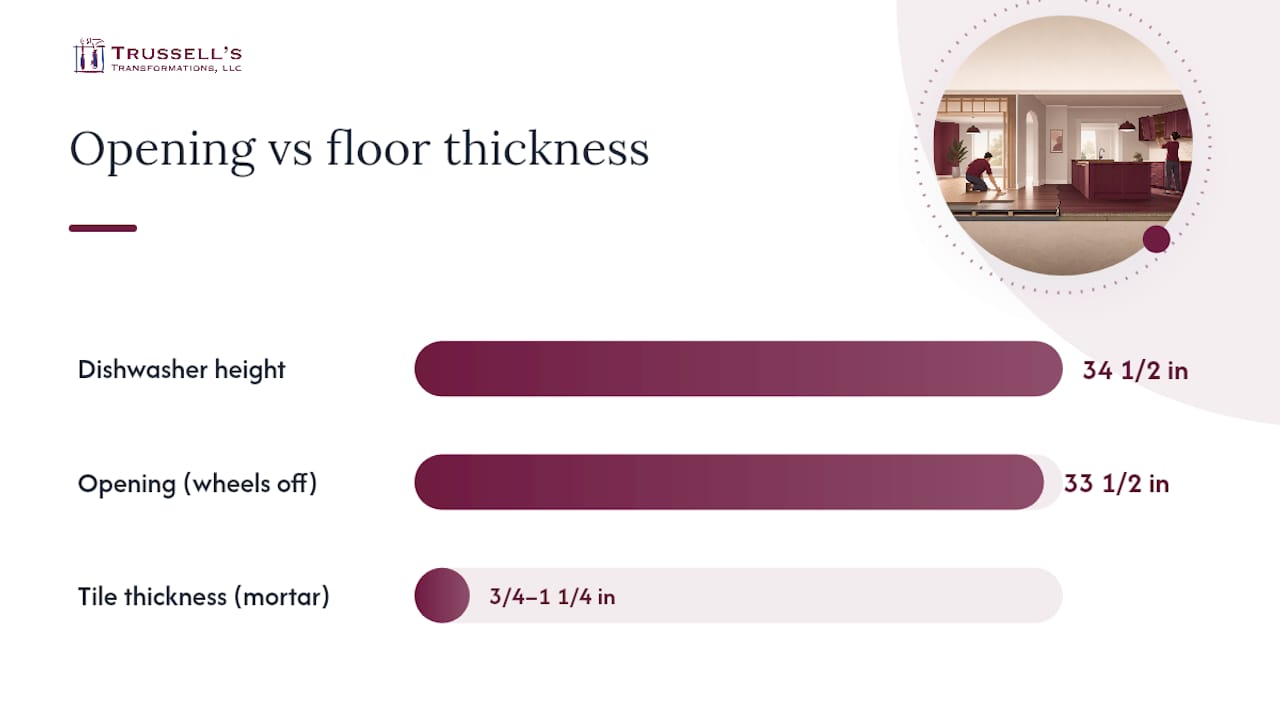

How Do Appliance Openings And Leveling Affect Your Decision? — Overview Diagram

How do material cost and labor time affect the install order?

The cost question comes down to two competing line items: material waste versus labor complexity.

Main cost drivers:

  • Hidden flooring under cabinets adds $240–$600 in material for a typical kitchen (floors-first)
  • Cutting flooring around existing cabinet bases adds measurable labor time (cabinets-first)
  • Rework costs when a floating floor buckles under cabinets can exceed the original flooring cost
  • Appliance shimming, if skipped, can require pulling cabinets to correct clearances
ScenarioTypical Cost ImpactWrong-Order Risk
Floors-first (tile or hardwood)+$240–$600 material for hidden areaLow; fixed floors tolerate cabinet weight
Cabinets-first (floating LVP/laminate)Saves material cost under cabinetsHigh; buckling and voided warranty if floor runs under cabinets
Cabinets-first (tile or hardwood)Saves material; requires more precise cutsMedium; visible gap if cabinets are replaced later
Wrong order (floating floor under cabinets)Full floor replacement possibleVery high; buckling, warranty void, structural damage

The 70% cabinets-first contractor preference reflects a cost-minimizing default that works well for floating floors. For tile and glued hardwood, the added material cost of floors-first is often worth it for the long-term flexibility and moisture protection it provides. If you’re planning to stay in the home for 10 or more years, floors-first for fixed materials is the better investment. For a full cost-versus-value breakdown, the numbers shift depending on material grade and kitchen size.

Practical installation tips by flooring type

Getting the sequence right is half the battle. Executing it correctly for your specific material is the other half.

Floating LVP and laminate

Always install cabinets first. Leave a 1/4"–1/2" expansion gap at every wall, toe kick, and fixed obstruction. This Old House recommends removing toe kicks and cutting trim to slide flooring under the cabinet base for a clean finish. Never nail or staple through the tongue of a floating plank to hold it in place near a cabinet base.

Glue-down LVP and engineered hardwood

Install flooring first. The adhesive bond creates a fixed floor, so expansion is not a concern. Protect the finished surface with rosin paper or cardboard during cabinet installation. Confirm the adhesive is fully cured (typically 24–72 hours per manufacturer spec) before setting cabinet bases.

Solid hardwood (nail or staple-down)

Flooring first is standard. Nail-down hardwood is a fixed floor and handles cabinet weight without buckling. Leave a 3/4" gap at walls for seasonal movement. Protect the surface during cabinet installation; hardwood scratches easily under heavy base cabinet slides.

Tile (ceramic, porcelain, natural stone)

Tile goes first in almost every case. The fixed surface sets the correct height for countertops and appliances, and running tile under cabinets protects the subfloor from water intrusion at the cabinet base. One exception: very expensive or fragile tile (think large-format marble slabs) may be installed after cabinets to reduce breakage risk during the cabinet install, but this requires precise shimming of the cabinet bases to finished-floor height.

If you have radiant heat under tile, confirm with the manufacturer whether heat mats should extend under the cabinet footprint. Most radiant heat manufacturers advise against running heat elements under fixed cabinetry.

Cork

For floating cork, cabinets go first. For glued cork, treat it like glue-down engineered wood and install flooring first. Confirm with the product manufacturer before scheduling, since cork density and adhesive type vary significantly by brand.

Pro Tip: Before scheduling any flooring trade, pull the installation instructions for your specific product and look for the phrase “do not install under cabinets” or “maintain expansion gap at all fixed objects.” That language, when present, settles the sequence question definitively and protects your warranty.

Where do cabinets and flooring fit in the remodel timeline?

Multi-trade coordination is where sequencing decisions become scheduling decisions. Here’s the practical order of work for a kitchen remodel:

  1. Demo (remove existing cabinets, flooring, and fixtures)
  2. Rough-in plumbing and electrical (move pipes, add circuits, install junction boxes)
  3. Inspections (rough-in sign-off before walls close)
  4. Drywall and paint (finish walls before cabinets go in)
  5. Cabinets (set base and upper cabinets; confirm finished-floor height for appliance bays)
  6. Flooring (install to toe-kick line for floating floors; full floor for tile/hardwood)
  7. Countertop templating (measure after cabinets are set and flooring is installed)
  8. Countertops installed (granite, quartz, or other surface)
  9. Backsplash and finish plumbing (sink, faucet, disposal hookup)
  10. Appliances delivered and installed (confirm opening heights before delivery day)

Leave 3–5 buffer days between cabinet installation and flooring cuts so crews aren’t working in the same tight space simultaneously. Saw setups for tile or hardwood need clear floor access, and cabinet installers need room to maneuver base units. Scheduling them back-to-back without a buffer is one of the most common sources of change orders on kitchen remodels.

Pro Tip: Confirm your finished floor thickness with the flooring installer before countertop templating. The countertop fabricator measures from the top of the cabinet, but the finished floor height affects appliance fit and base trim. A 3/4" discrepancy between what was planned and what was installed can mean re-templating the countertop.

How Trussell’s Transformations handles sequencing on real projects

Trussell’s Transformations brings over 25 years of remodeling experience to every kitchen project in Albuquerque and the surrounding area. Christy Trussell and the team have worked through every flooring-and-cabinet combination described in this article, including the appliance traps and floating-floor warranty issues that catch homeowners off guard.

The firm’s project workflow for sequencing decisions includes:

  • On-site measurement of every appliance opening before scheduling any trades
  • Manufacturer spec review for the chosen flooring product, confirming expansion gap requirements and cabinet-placement language
  • Finished-floor height documentation shared with the countertop fabricator before templating
  • Trade coordination with 3–5 day buffers between cabinet and flooring crews
  • Appliance bay shimming using plywood sleeper strips when cabinets are installed before flooring
  • Written confirmation of the chosen sequence shared with the homeowner before work begins

For homeowners who want to understand cabinet installation options in more detail before committing to a sequence, the team walks through both DIY and professional installation paths. Financing options are also available for homeowners who want to complete the full remodel in one coordinated project rather than phasing it over time.

The mistake most homeowners don’t catch until it’s too late

The appliance trap is the one that stings most. A homeowner installs beautiful LVP throughout the kitchen, the cabinets go in on top, and everything looks perfect until the dishwasher needs service two years later. The appliance is now sitting on a subfloor that’s 3/8" lower than the surrounding floor, the wheels are locked against the LVP edge, and pulling it out means either damaging the flooring or removing the adjacent cabinet. A $150 shimming job at install time would have prevented a $600–$1,200 repair.

The second most common mistake is pinning a floating floor under cabinets. It seems harmless at first. The floor looks flat and tight. Then summer arrives, humidity rises, and the planks have nowhere to expand. Buckling starts at the cabinet base and works outward. The manufacturer’s warranty is void the moment a fixed load sits on a floating floor, so the homeowner absorbs the full replacement cost.

Buckled Floating Floor Near Cabinet Base

The third issue is subtler: mismatched countertop height caused by a flooring thickness change mid-project. When the flooring installer substitutes a product that’s 1/4" thicker than what was specified, and the countertop was already templated, the base cabinets end up slightly low. The countertop overhangs the front face frame instead of sitting flush. Confirming floor thickness in writing to the general contractor before templating eliminates this entirely.

Trussell’s Transformations can handle the sequencing for you

Deciding whether flooring or cabinets go first is straightforward once you know your material. Executing it correctly across multiple trades, appliance specs, and countertop timelines is where most kitchen remodels run into trouble.

Trussell&Amp;Apos;S Transformations

Trussell’s Transformations handles the full sequence for kitchen remodels in Albuquerque: on-site measurements, manufacturer spec checks, trade coordination, cabinet installation, and finish flooring. You get one point of contact managing the order of work from demo through appliance hookup, with no guesswork about which crew needs to be where and when. Financing options are available for homeowners who want to complete the project in a single, coordinated remodel rather than phasing it over multiple seasons. Contact Trussell’s Transformations to schedule your on-site measurement and get a clear project sequence before any work begins.

Sources

Before finalizing your install sequence, pull the manufacturer’s installation instructions for your specific flooring product. The cabinet-placement and expansion-gap language in those instructions is the authoritative answer for your exact material, and it’s what a contractor should be referencing before scheduling trades.
