Most New Mexico property owners pay between $7 and $14 per square foot installed for TPO roofing, with the biggest swings coming from membrane thickness, attachment method, and insulation choice. Tear-off versus recover and Albuquerque permit fees shift the number further. A typical mid-grade commercial job lands closer to the middle of that range once you add insulation and labor.
TL;DR:
- Costs for TPO roofing in New Mexico range from $7 to $14 per square foot, depending on membrane thickness, attachment method, and insulation R-value.
- A typical commercial roof installation for 10,000 square feet costs between $70,000 and $140,000, with premium options favoring thicker membranes and certified installation.
- permit fees in Albuquerque scale with project valuation, usually between $50 and $80 for projects in the $501 to $20,000 range, and require licensed contractors and scheduling inspections.
- Choosing recover over tear-off can reduce costs if a core sample confirms the existing roof is dry and within layer limits, avoiding demolition expenses.
- Prioritizing detailed, specification-matched bids and verifying contractor certification ensures long-term performance and protects warranty coverage.
Table of Contents
- 1. Installed cost bands and worked examples by roof size
- 2. What actually drives TPO roofing cost up or down
- 3. How Albuquerque permits and inspections affect your price
- 4. How to evaluate and hire a qualified TPO contractor
- 5. Ways to lower your net roofing cost without cutting corners
- 6. Trussell’s Transformations: local roofing experience in New Mexico
- 7. Why labor costs shift once you leave Albuquerque
- 8. What to expect from contractor selection to completion
- 9. Commercial versus residential TPO roofing costs in New Mexico
- Why the cheapest TPO bid rarely stays the cheapest roof
- Get a local, written TPO roofing estimate
- FAQ
- Sources
1. Installed cost bands and worked examples by roof size
TPO pricing moves in predictable steps once you know the specification. Economy jobs use 45-mil to 60-mil membrane mechanically attached to the deck, while premium jobs use 80-mil membrane fully adhered for better wind uplift and puncture resistance. According to TRB’s 2026 cost breakdown, 60-mil mechanically attached systems run about $7 to $12 per square foot, 60-mil fully adhered systems run $8 to $13, and 80-mil systems run $9 to $14, with insulation R-value adding to the total on top of the membrane cost.
Here’s how that plays out across common building sizes, using the low and high ends of those bands:
- 2,000 square feet: roughly $14,000 to $28,000 installed, depending on mil thickness and attachment.
- 10,000 square feet: roughly $70,000 to $140,000, with tear-off, insulation, and accessories pushing toward the higher end.
- 20,000 square feet: roughly $140,000 to $280,000, where labor efficiencies per square foot start to offset material upgrades.
These totals bundle membrane, polyiso insulation, labor, tear-off or recover prep, flashing and drain detailing, and mobilization. A manufacturer-certified install, which protects a longer warranty term, typically carries a modest premium over a standard labor-only install because the contractor pays for certification and the manufacturer inspects the finished roof before issuing coverage. For a side-by-side look at how TPO stacks up against another common single-ply option, see our comparison of TPO and EPDM roofing for Albuquerque homes.
2. What actually drives TPO roofing cost up or down
Every dollar in a TPO estimate traces back to one of a handful of choices. Understanding them lets you see exactly where a bid is padded or justified.
- Membrane thickness: 45-mil membrane costs the least but offers the thinnest wear layer; 60-mil is the common commercial standard; 80-mil adds puncture and hail resistance that matters in New Mexico’s monsoon season.
- Attachment method: mechanically attached systems cost less to install but show more fastener patterns over time, fully adhered systems cost more upfront but perform better in high wind, and ballasted systems need structural capacity for the rock or pavers.
- Insulation R-value: polyiso boards that meet or exceed New Mexico’s energy code minimums add material cost but lower long-term cooling and heating bills.
- Tear-off versus recover: removing old roofing and disposing of it costs more than overlaying a sound existing roof, but recover is only allowed when a core sample shows acceptable moisture and layer count.
- Access and detailing: steep access, numerous roof penetrations, and complex drain or flashing work all add labor hours that a flat, open roof wouldn’t need.
- Warranty length: a 20-year manufacturer warranty costs more than a 10-year labor-only warranty because it requires certified installation and manufacturer inspection.
Core sampling plays a bigger role here than many owners expect. It is often the deciding factor in whether a project qualifies as a lower-cost recover or must become a full tear-off, and Albuquerque’s permitting process can require one before work begins.
3. How Albuquerque permits and inspections affect your price
Permit fees are a small but unavoidable line item on any commercial re-roof in Albuquerque, and skipping them costs far more than paying them upfront.
- The city’s commercial re-roof fee schedule scales with project valuation, charging around $50 for projects valued at $501 to $5,000 and around $80 for projects in the $10,001 to $20,000 range, with higher tiers for larger jobs.
- Only a New Mexico-licensed contractor can legally pull a commercial re-roof permit, which rules out unlicensed handyman bids entirely.
- Inspectors typically expect to review the work at roughly 50% completion, so your contractor needs to schedule that inspection into the project timeline rather than treat it as an afterthought.
- Starting work without a permit risks a stop-work order and doubled fees, according to the city’s BuildSafe application guidance.
One fee tier under Albuquerque’s commercial re-roof schedule runs in the range of typical fees for projects valued between $10,001 and $20,000, reflecting that permit costs scale with your project’s declared value rather than staying flat., a reminder that permit costs scale with your project’s declared value rather than staying flat. Budgeting for the permit and the mid-project inspection window up front avoids schedule surprises later.
4. How to evaluate and hire a qualified TPO contractor
A low bid that skips licensing, insurance, or proper warranty paperwork isn’t actually cheaper once something goes wrong. Before you sign anything, confirm the basics.
- Verify the contractor holds an active New Mexico contractor’s license and carries general liability and workers’ compensation coverage.
- Ask whether the crew is manufacturer-certified for the TPO product they’re proposing, since that certification is usually what unlocks the longer warranty terms.
- Request examples of TPO installs the contractor has completed in New Mexico, where sun exposure and hail resistance matter more than in milder climates.
- Compare written, line-item bids built to identical specifications: same mil thickness, same attachment method, same insulation R-value.
Red flags include a contractor who hesitates to pull permits, warranty language that stays vague about coverage length or exclusions, or a bid that skips a written specification entirely. Our guide to vetting Albuquerque roofing contractors walks through the reference-checking process in more detail.
Pro Tip: Ask every bidder for the exact same spec sheet before quoting, then compare only the price difference, not the scope difference.
5. Ways to lower your net roofing cost without cutting corners
A few choices can meaningfully reduce what you pay without sacrificing performance. Recover instead of tear-off when a core sample confirms the existing roof is dry and within the allowed layer count, since skipping demolition and disposal saves real money. Consider upgrading insulation R-value even though it raises the upfront bid, since TPO’s reflective surface combined with better insulation can lower cooling costs in New Mexico’s long summer heat, based on Department of Energy cool-roof guidance.
- Ask your contractor whether current utility or ENERGY STAR-linked incentives apply to a reflective roof upgrade in your area.
- Compare financing options, including contractor-offered 0% financing, a traditional loan, or phasing a large commercial roof into sections over separate budget cycles.
- Weigh the lifecycle cost of a longer warranty against the lower upfront price of a shorter one, since reroofing sooner than planned erases any initial savings.
6. Trussell’s Transformations: local roofing experience in New Mexico
We have experience working on Albuquerque homes and properties involving roofing installation and replacement, alongside kitchen and bathroom remodeling. We help coordinate the permit and inspection steps a commercial or residential re-roof requires, and work toward certified installs to support warranty terms. Before your on-site estimate, have your roof’s square footage, any history of past repairs or leaks, and your preferred warranty length ready. See our roofing services page for the full scope of what we cover.

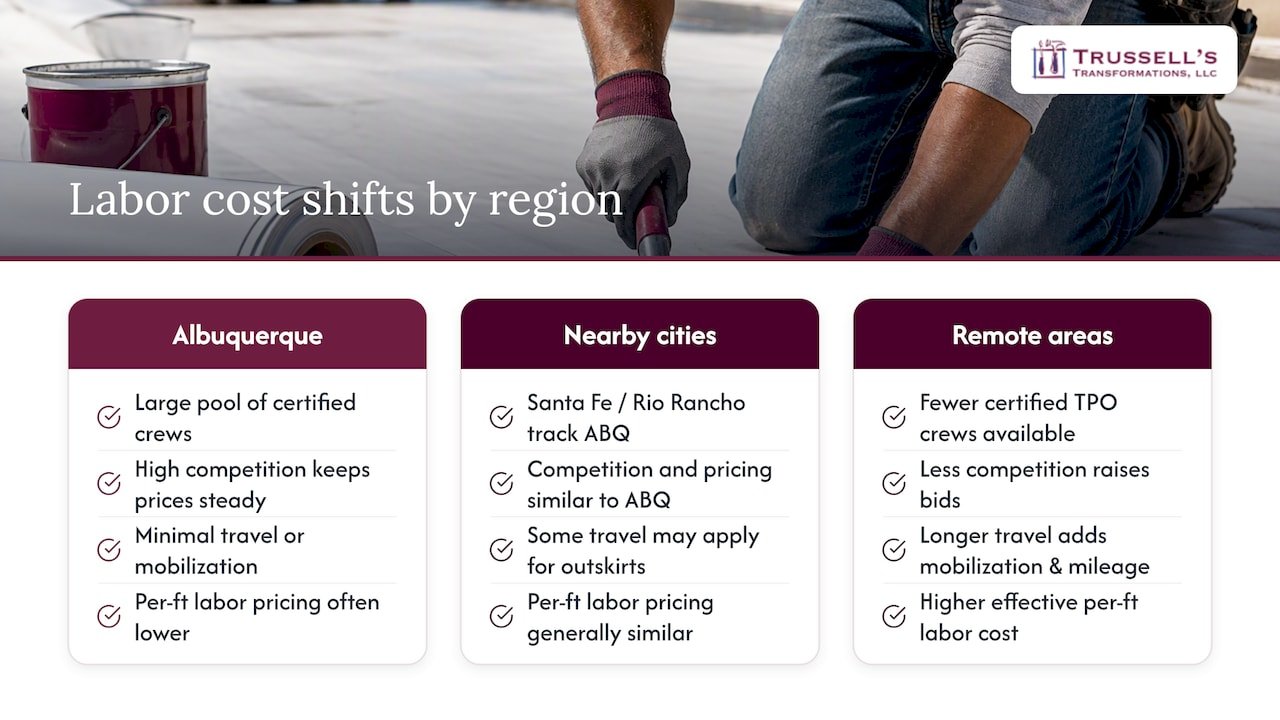

7. Why labor costs shift once you leave Albuquerque
Labor rates for TPO installation aren’t uniform across New Mexico. Albuquerque’s larger pool of licensed, certified crews and higher project volume tends to keep competition active, which can hold labor pricing steady relative to smaller markets. In more rural parts of the state, fewer certified TPO crews means a contractor may need to travel farther, adding mobilization time and mileage to a bid that wouldn’t show up on an in-town project.
Santa Fe and Rio Rancho sit close enough to Albuquerque’s labor market that pricing often tracks similarly, while more remote areas of the state, where a certified crew has to haul equipment and materials a longer distance, tend to see higher effective labor costs even when the published per-square-foot material price looks the same. Property owners outside the metro area should ask contractors directly whether a quote includes travel time, since that’s often where regional price gaps actually come from rather than from the roofing materials themselves.
Smaller or more isolated commercial buildings can also face higher per-square-foot pricing than a large Albuquerque warehouse simply because fixed costs like mobilization and equipment transport get spread across less roof area. When comparing bids from contractors based in different parts of the state, it helps to ask for the labor and mobilization line items separately from the material and membrane costs so you can see exactly what the distance is adding.

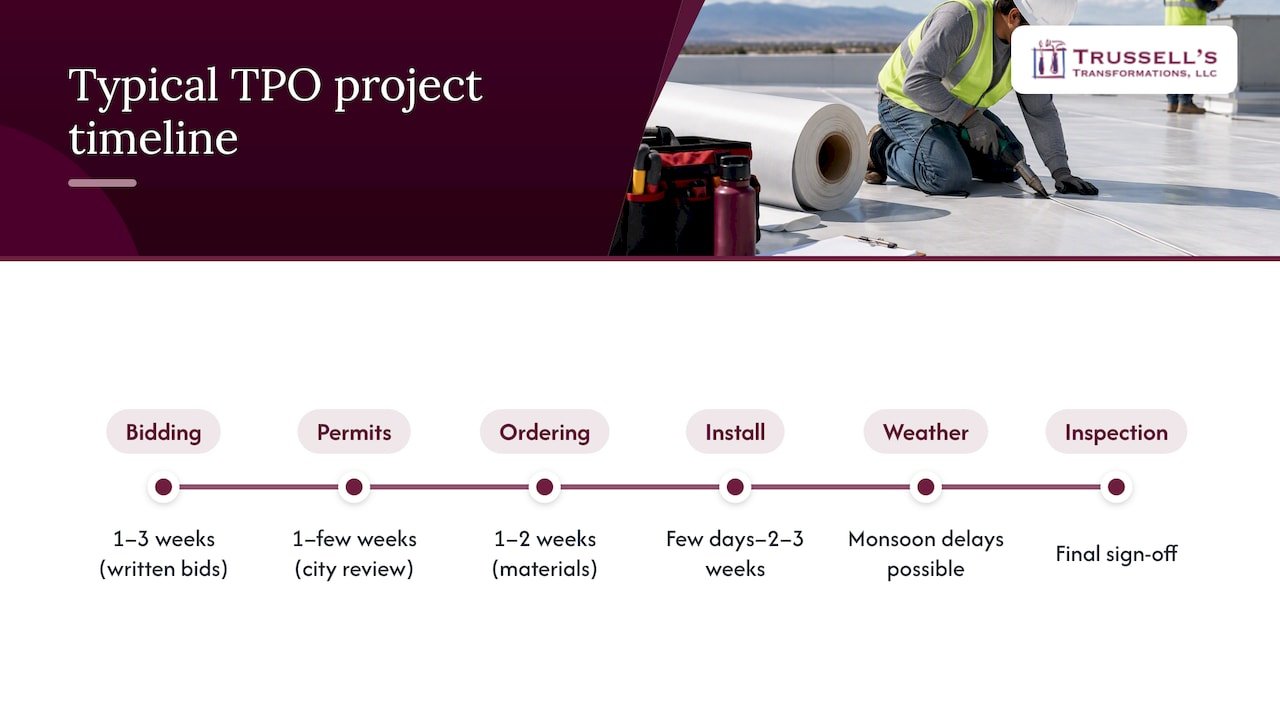

8. What to expect from contractor selection to completion
A typical TPO roofing project moves through a few distinct phases, and knowing the rough timeline helps you plan around it. Getting multiple written bids usually takes one to three weeks, since a responsible contractor needs time to measure, assess tear-off versus recover feasibility, and sometimes pull a core sample before quoting. Once you select a contractor, permit submission and approval through the city typically adds another one to a few weeks, depending on project valuation and current permit office volume.
Material ordering and scheduling the crew generally takes another one to two weeks, particularly for larger quantities of membrane and insulation board. The installation itself, for a mid-sized commercial roof, often runs anywhere from a few days to two or three weeks depending on square footage, access, and weather. New Mexico’s dry season offers more predictable installation windows than monsoon months, when afternoon storms can pause work on an exposed deck.
Altogether, a straightforward commercial TPO project from first bid to final inspection often spans six to ten weeks, while larger or more complex jobs with extensive tear-off or structural repairs can run longer.
9. Commercial versus residential TPO roofing costs in New Mexico
TPO is primarily a commercial product, used on flat or low-slope roofs like warehouses, retail buildings, and multi-family properties, but it does show up on residential additions, flat-roofed sections of a home, or accessory structures. The cost structure differs in a few consistent ways between the two.
Commercial projects benefit from scale: a large, open roof with few penetrations costs less per square foot than a small, cut-up residential section with multiple vents, skylights, or parapet walls. Residential TPO applications, often limited to a porch roof, addition, or flat section of a larger pitched roof, tend to carry a higher effective per-square-foot price because the fixed costs of mobilization, flashing detail, and crew setup get spread across far less area.
Permitting also differs. Commercial re-roofs in Albuquerque follow the fee schedule and licensing rules described earlier, while a smaller residential flat-roof section may fall under different permit thresholds depending on project valuation. Either way, confirming with the city which tier your project falls into before budgeting avoids a mismatch between your estimate and your actual permit cost.
Why the cheapest TPO bid rarely stays the cheapest roof
The conventional advice on TPO pricing stops at the per-square-foot number, and that’s exactly where it falls short. A bid that looks $2 per square foot cheaper often skips the core sample, assumes recover when tear-off is actually required, or quotes a shorter warranty without saying so outright. New Mexico’s intense sun and hail exposure make membrane thickness and attachment method matter more here than in milder climates, so the spec gap between two bids usually explains the price gap better than the contractor’s margin does.
What the research actually supports is this: get every bid written to the same specification before comparing price, and treat the permit and core-sample step as part of the estimate, not an add-on that shows up later. Readers who prioritize spec-matching over sticker price consistently end up with a roof that performs for its full warranty term instead of needing attention again in year eight.
— Christy Trussell
Get a local, written TPO roofing estimate
We handle the permit paperwork, coordinate inspections, and work toward manufacturer-certified installs so your TPO roof’s warranty actually holds up, with financing options available if you’d rather spread the cost over time.
If you’re comparing bids or just want a clear, line-item quote for your property, request a site visit through our roofing installation and repair services page and we’ll walk the roof with you before anything is written down.
FAQ
How much does a TPO roof cost per square?
TPO roofing typically costs between $7 and $14 per square foot installed, with the exact figure depending on membrane thickness, attachment method, and insulation choice. For a rough estimate, multiply the square footage by this rate to understand potential costs. See more details here.
How much does it cost to replace a flat roof?
Flat roof replacement costs vary significantly by material, region, and building size, and figures from other markets don’t carry over directly to New Mexico pricing. For a New Mexico-specific estimate, the TPO cost ranges above and a written contractor bid are the most reliable starting points.
Is $30,000 too much for a roof?
Whether a given budget is reasonable depends entirely on the roof’s size, membrane spec, and whether the job includes tear-off, insulation upgrades, and permit fees. Costs generally fall within the typical $7 to $14 per square foot installed range. See details here.
How much does it cost to replace a roof in New Mexico?
TPO roof replacement in New Mexico typically runs $7 to $14 per square foot installed, with Albuquerque commercial projects also carrying permit fees that scale with project valuation. Tear-off, insulation upgrades, and warranty length all move the final number within that range.
Does recovering an existing roof cost less than tearing it off?
Recovering an existing TPO or compatible roof generally costs less than a full tear-off because it skips demolition and disposal labor. It’s only allowed when a core sample confirms the existing roof is dry and within the layer limits set by Albuquerque’s permitting process.
